Manhattan
Time Warner Center
Design Development/Construction Management
Project Manager for Skidmore, Owings & Merrill LLP during Design Development (1999-2001)
Project Manager for Turner Construction Company during Construction (2001-2004)

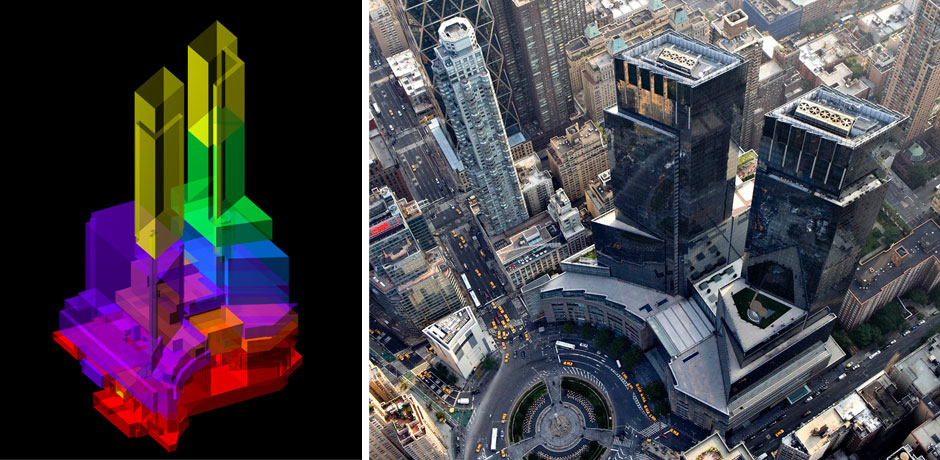

2.7 million SF mixed use development at Columbus Circle
- Managed Time Warner component for base building architect and assisted in coordination of multiple tenants and uses in single structure.
- Led green building team, on pilot LEED Interiors program
- Coordinated design and construction documents with between owner, architects, engineers and specialty consultants
- Developed estimates during pre-construction, created Requests for Proposals for specialty consultants
- Monitored base building schedule.
- Bought out trade packages and monitored the shop drawings, submittals and change orders for millwork and flooring trades
- Created monthly project reports on construction status. Assisted in installation coordination with field staff.
- Negotiated construction issues with design team, owner and subcontractors
- Tracked participation of minority and women owned businesses.done
Pre-construction fee: $280,000
Construction contract value: approximately $200 million
